RISK ii

What is a Risk Register?

Our safety specialists discuss

A Risk Register is an essential Risk Management Process tool. Representing the identified current recorded and assessed risks present in an organisation, it is a step-by-step guide to the close-out process. Ultimately, the risk register presents the Accountable Manager with a window into the immediate safety and quality status of the company.

Litson and Associates’ safety specialists have created a sample risk register flow diagram which consists of three phases, to demonstrate the easy implementation of this useful tool

RISK REGISTER FLOW DIAGRAM

On receipt of a completed audit report with any non-conformance/findings noted, it is suggested that the following steps and processes be followed:

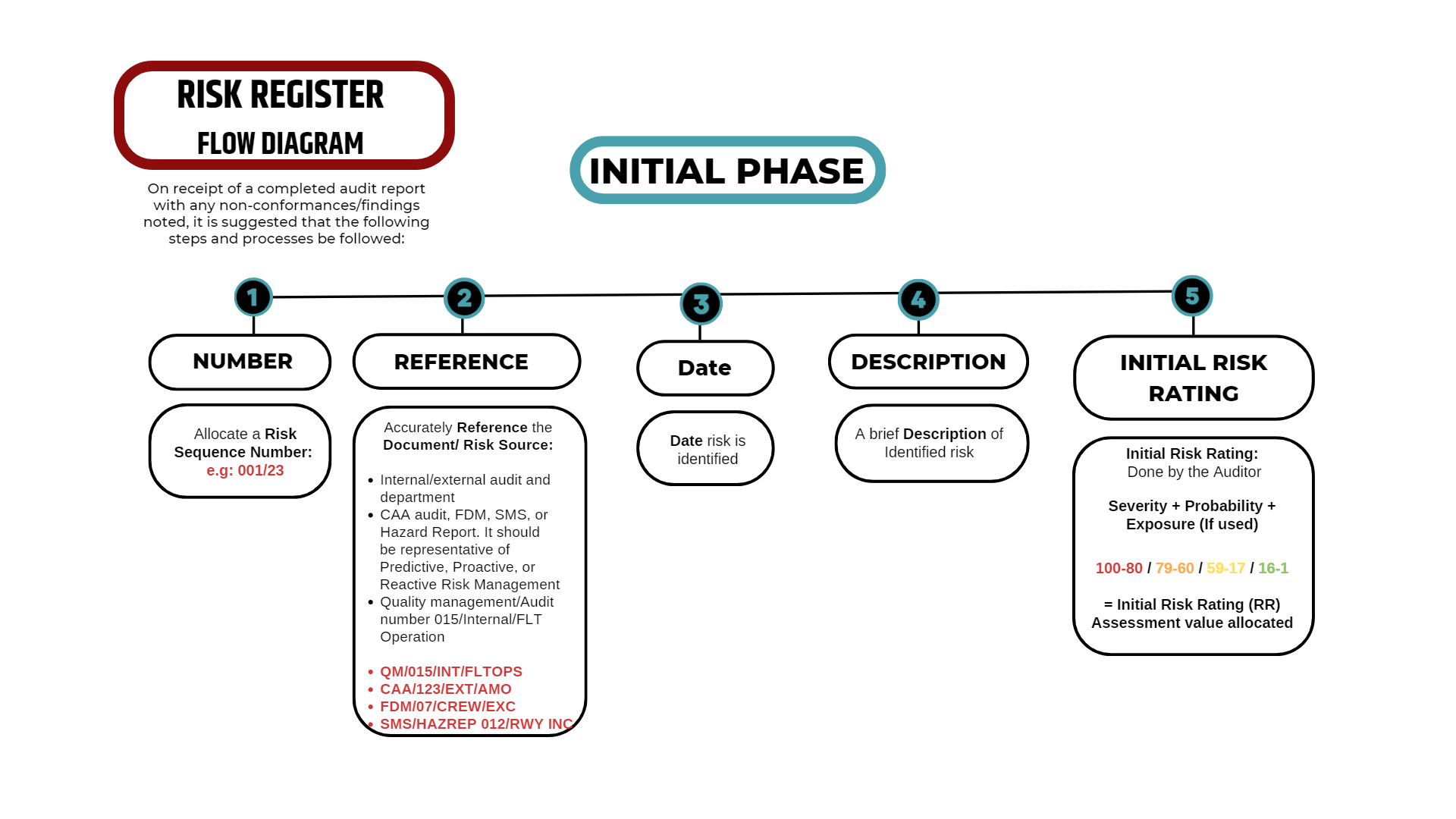

INITIAL PHASE

Risk Register Flow Diagram - INITIAL PHASE
INITIAL PHASE
  1. NUMBER
    • Allocate a Risk Sequence Number: eg: 001/123
  2. REFERENCE

Accurately Reference the Document/Risk Source:

    • Internal/external audit and department
    • CAA audit, FDM, SMS, or Hazard Report. It should be representative of Predictive, Proactive or Reactive Risk Management
    • Quality management/Audit number 015/Internal/FLT Operations
    • QM/015/INT/FLTOPS
    • CAA/123/EXT/AMO
    • FDM/007/CREW/ EXCEEDANCE
    • SMS/HAZREP 012/RWY INCUR
  1. DATE
    • Date risk is identified
  2. DESCRIPTION
    • A brief description of Identified risk
  3. INITIAL RISK RATING
    • Initial Risk Rating: Done by the auditor
    • Severity + Probability + Exposure (if used)
    • 100-80 / 79-60 / 59-17 / 16-1

= Initial Risk Rating (RR) Assessment value allocated

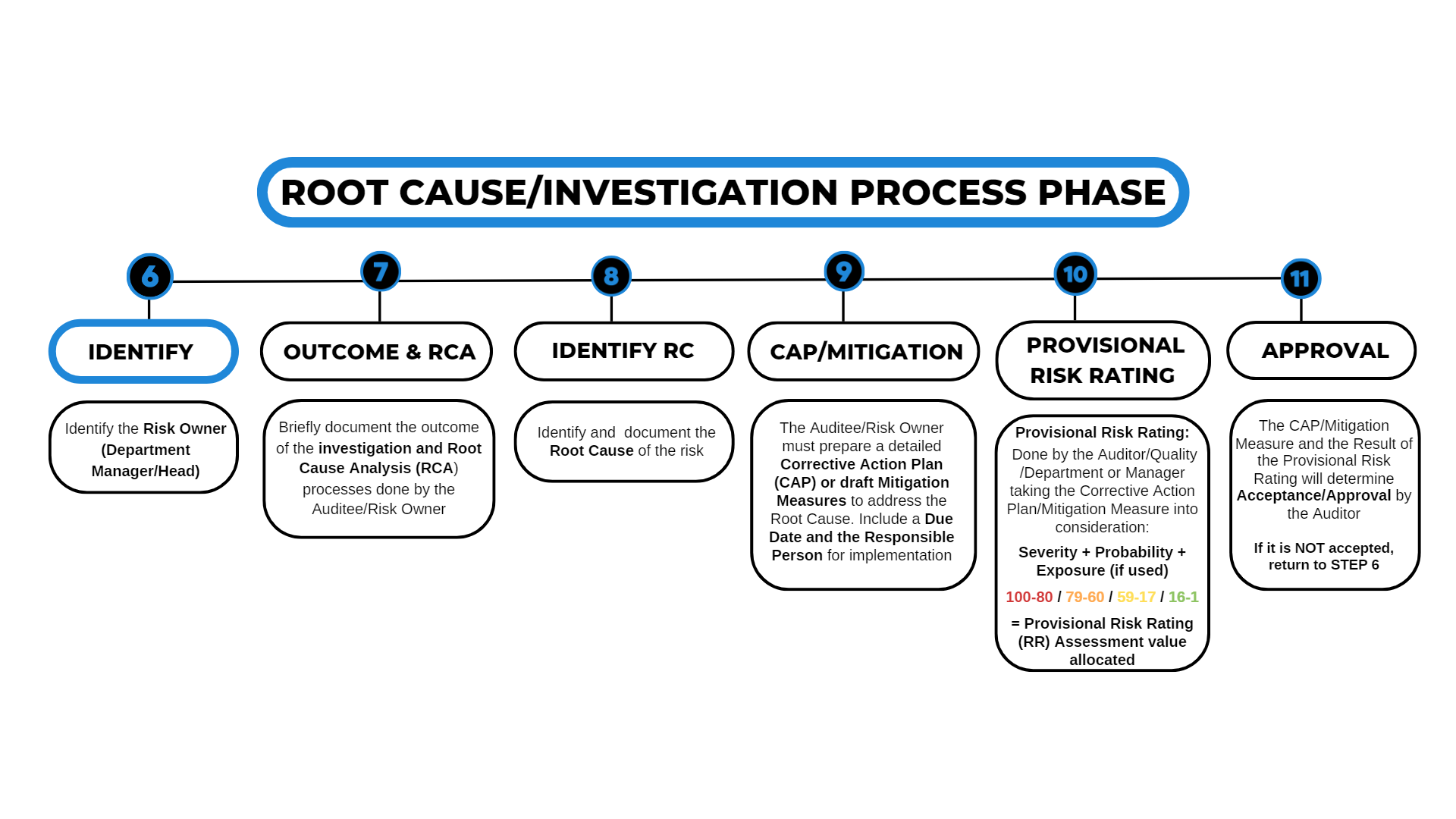

ROOT CAUSE /INVESTIGATION PROCESS PHASE

Risk Register Flow Diagram - ROOT CAUSE/INVESTIGATION PROCESS PHASE
ROOT CAUSE/INVESTIGATION PROCESS PHASE

6. IDENTIFY

    • Identify the Risk Owner (Department Manager/Head)

7. OUTCOME & RCA

    • Briefly document the outcome of the investigation and Root Cause Analysis (RCA) processes done by the Auditee/Risk Owner

8. IDENTIFY RC

    • Identify and document the Root Cause of the risk

9. CAP/MITIGATION

    • The Auditee/Risk Owner must prepare a detailed Corrective Action Plan (CAP) or draft Mitigation Measures to address the Root Cause. Include a Due Date and the Responsible Person for implementation

10. PROVISIONAL RISK RATING

    • Provisional Risk Rating: Done by the Auditor/Quality Department/Manager taking the Corrective Action Plan/Mitigation Measure into consideration:
    • Severity + Probability + Exposure (if used)
    • 100-80 / 79-60 / 59-17 / 16-1

= Provisional Risk Rating (RR) Assessment value allocated

11. APPROVAL

    • The CAP/Mitigation Measure and the Result of the Provisional Risk Rating will determine Acceptance/Approval by the Auditor

If it is NOT accepted, return to STEP 6

IMPLEMENTATION AND MONITORING PHASE

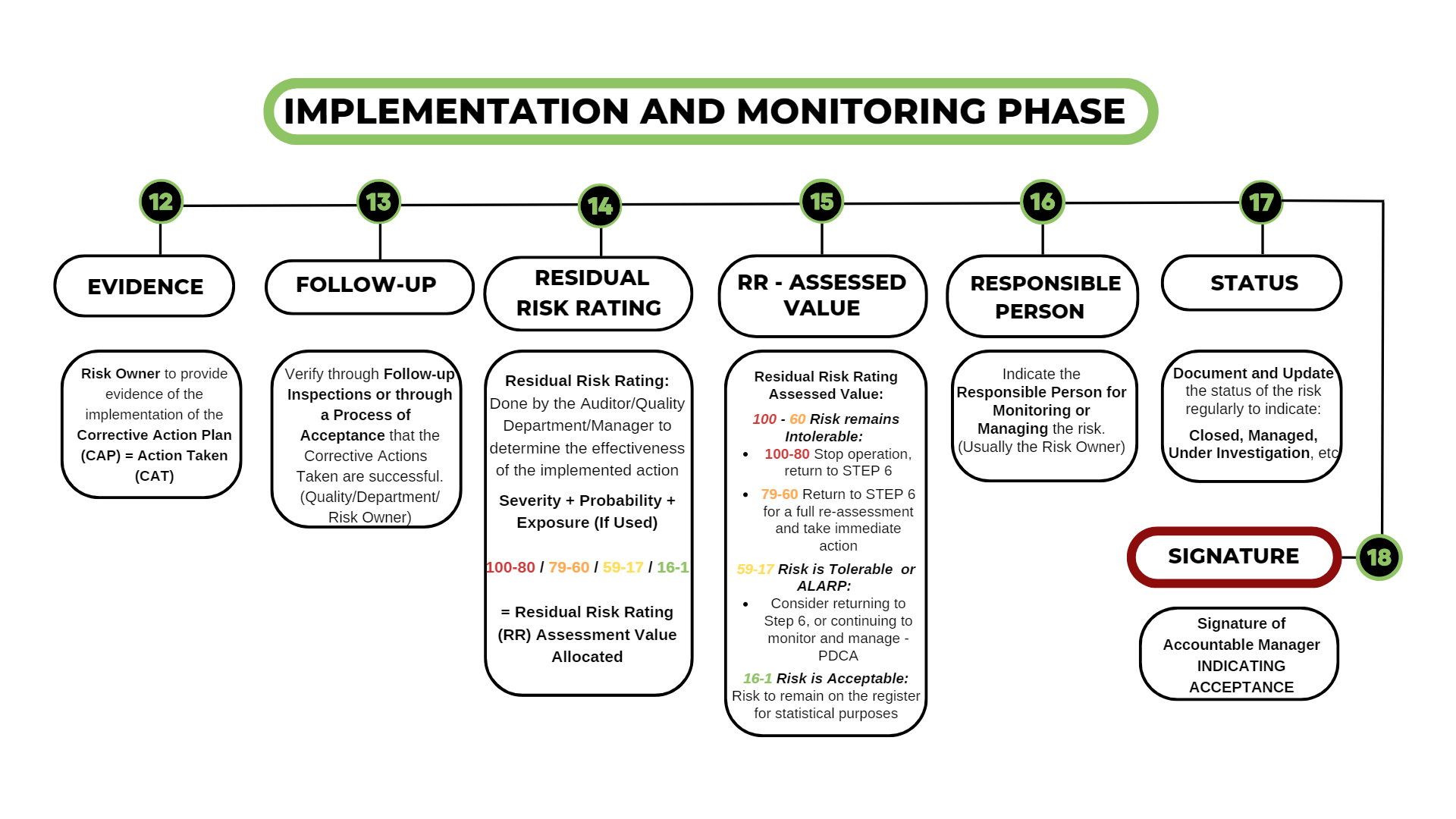

Risk Register Flow Diagram - IMPLEMENTATION AND MONITORING PHASE
IMPLEMENTATION AND MONITORING PHASE

12. EVIDENCE

    • Risk Owner to provide evidence of the implementation of the Corrective Action Plan (CAP) = Action Taken (CAT)

13. FOLLOW-UP

    • Verify through Follow-up Inspections or through a Process of Acceptance that the Corrective Actions Taken are successful (Quality/Department/

      Risk Owner)

14. RESIDUAL RISK RATING

Residual Risk Rating: Done by the Auditor/Quality Department/Manager to determine the effectiveness of the implemented action

    • Severity + Probability + Exposure (If Used)
    • 100-80 / 79-60 / 59-17 / 16-1

= Residual Risk Rating (RR) Assessment Value Allocated

15. RR – ASSESSED VALUE

Residual Risk Rating Assessed Value:

100 – 60 Risk remains Intolerable:

        • 100-80 Stop operation, return to STEP 6
        • 79-60 Return to STEP 6 for a full re-assessment and take immediate action

59-17 Risk is Tolerable or ALARP:

        • Consider returning to Step 6, or continuing to monitor and manage – PDCA

16-1 Risk is Acceptable:

        • Risk to remain on the register for statistical purposes

16. RESPONSIBLE PERSON

    • Indicate the Responsible Person for Monitoring or Managing the risk. (Usually the Risk Owner)

17. STATUS

Document and Update the status of the risk regularly to indicate:

    • Closed, Managed, Under Investigation, etc

18. SIGNATURE

    • Signature OF Accountable Manager INDICATING ACCEPTANCE
